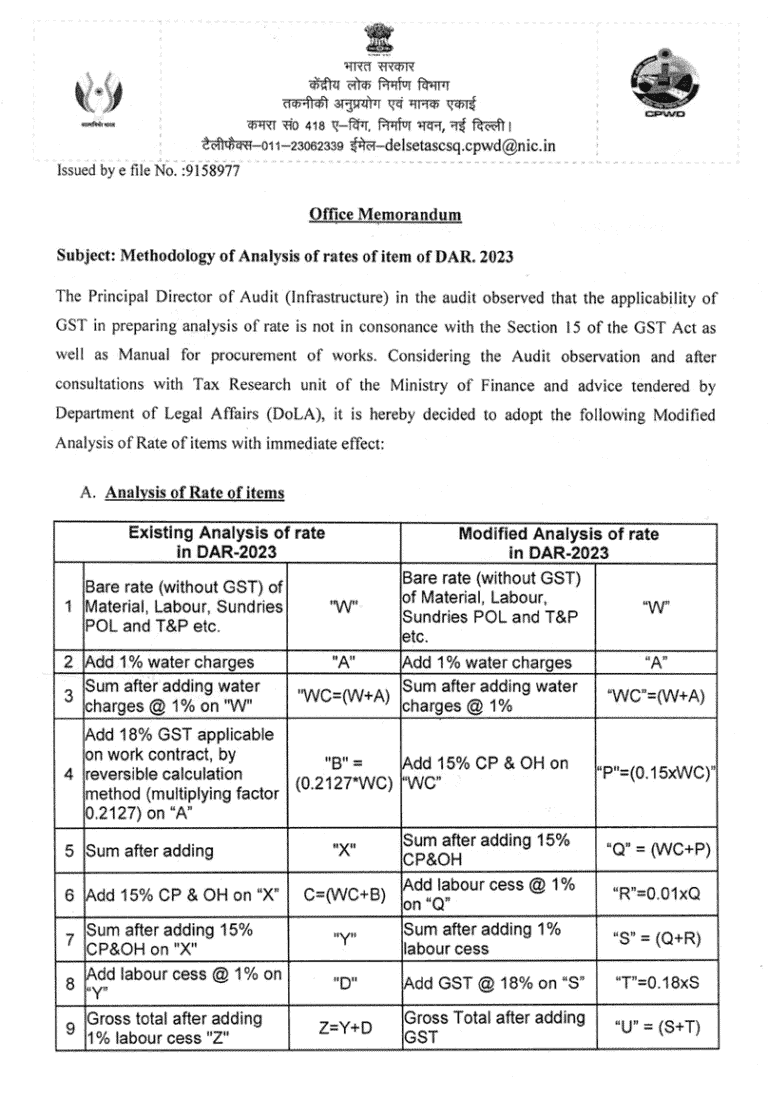

Prepare estimates. Justify every rate.
Estimation & Justification software for CPWD’s Delhi Schedule of Rates (DSR) & Railways USSOR.
Civil DSR-2023 (Old) · Civil DSR-2023 (New) · Civil USSOR-2021 · E&M DSR-2025 (Coming soon)
Built on Schedule of Rates (SoR) you already use.
- Branch
- Civil
- Civil works
- GST
- 18%
- Per the OM
- Analysis
- DAR
- Delhi Analysis of Rates, item by item
- Correction slips
- Applied
- As they are issued
- Branch
- Civil
- Civil works
- GST
- 21.27%
- As published
- Analysis
- DAR
- Delhi Analysis of Rates, item by item
- Correction slips
- Applied
- As they are issued
- Branch
- Civil
- Civil works
- GST
- 14.05%
- As published
- Analysis
- AoR
- Analysis of Rates, item by item
- Correction slips
- Applied
- As they are issued
- Branch
- E&M
- Electrical & mechanical
- Status
- Coming soon
- Same search, analysis and justification as the civil schedules
Who is Costimator for?
One tool for the Department, Consultant & Contractor.
- Department side: Government Engineers, PSU Engineers, Railway Engineers, Draftsmen
- Consultant side: Private Engineers, Consultants, Architects, PMC
- Contractor side: Contractors, Bidders, Estimators, Quantity Surveyors
Excel Problem with manual methods
A wrong figure in Excel looks exactly like a right one.
Approximations made in good faith can still lead to audit observations and vigilance inquiries.
A row the SUM range missed
A cement rate buried in a sub-item
One change, every sheet redone
A correction slip never applied
Two files, two cement rates
Why choose Costimator
Costimator takes the Excel out of estimates and justifications.
Estimation
From Finding the Right Item to a Finished Estimate.
| Code | Description | Unit | Rate (₹) | |
|---|---|---|---|---|
| 2.1 | Earth work in surface excavation not exceeding 30 cm in depth but exceeding 1.5 m in width as well as 10 sqm on plan including getting out and disposal of excavated earth… | |||
| 2.1.1 | All kinds of soil | sqm | 126.35 | |
| 2.2 | Earth work by mechinical / manual means in rough excavation, banking excavated earth in layers not exceeding 20cm in depth… | |||
| 2.2.1 | All kinds of soil | cum | 384.65 | |
| 2.3 | Banking excavated earth by mechanical / manual means in layers not exceeding 20 cm in depth… | |||
| 2.3.1 | All kinds of soil | cum | 192.55 | |
| 2.4 | Deduct for not rolling with power roller of minimum 8 tonnes for banking excavated earth in layers not exceeding 20 cm in depth. | cum | 5.10 | |
| 2.5 | Deduct for not watering the excavated earth for banking | cum | 13.85 | |
| 2.6 | Earth work in excavation by mechanical means (Hydraulic excavator)/manual means over areas (exceeding 30 cm in depth, 1.5 m in width as well as 10 sqm on plan)… | |||
| 2.6.1 | All kinds of soil | cum | 172.75 | |
| 2.7 | Earth work in excavation by mechanical means (Hydraulic excavator)/manual means over areas (exceeding 30 cm in depth, 1.5 m in width as well as 10 sqm on plan)… | |||
| 2.7.1 | Ordinary rock | cum | 485.45 | |
| 2.7.2 | Hard rock (requiring blasting) | cum | 850.85 | |
| 2.7.3 | Hard rock (blasting prohibited) | cum | 1,394.30 | |
| 2.8 | Earth work in excavation by mechanical means (Hydraulic excavator) / manual means in foundation trenches or drains (not exceeding 1.5 m in width or 10 sqm on plan)… | |||
| 2.8.1 | All kinds of soil. | cum | 253.30 | |
| 2.9 | Excavation work by mechanical means (Hydraulic excavator)/ manual means in foundation trenches or drains (not exceeding 1.5m in width or 10 sqm on plan)… | |||
| 2.9.1 | Ordinary rock | cum | 615.90 | |
| 2.9.2 | Hard rock (requiring blasting) | cum | 1,021.45 | |
| 2.9.3 | Hard rock (blasting prohibited) | cum | 1,482.00 | |
| Code | Description | Unit | Rate (₹) | |
|---|---|---|---|---|
| 4.1 | Providing and laying in position cement concrete of specified grade excluding the cost of centering and shuttering - All work up to plinth level : | |||
| 4.1.2 | 1:1½:3 (1 Cement: 1½ coarse sand (zone-III) derived from natural sources : 3 graded stone aggregate 20 mm nominal size derived from natural sources) | cum | 8,115.95 | |
| 4.1.2A | 1:1.5:3 (1 Cement: 1.5 coarse sand (zone-III) including manufactured sand derived from Recycled Concrete Aggregate (RCA) up to 25% : 3 graded stone aggregate… | cum | 7,908.65 | |
| 4.1.3 | 1:2:4 (1 cement : 2 coarse sand (zone-III) derived from natural sources : 4 graded stone aggregate 20 mm nominal size derived from natural sources) | cum | 7,666.05 | |
| 4.1.3A | 1:2:4 (1 cement : 2 coarse sand (zone-III) including manufactured sand derived from Recycled Concrete Aggregate (RCA) up to 25% : 4 graded stone aggregate… | cum | 7,448.40 | |
| 4.1.4 | 1:2:4 (1 Cement : 2 coarse sand (zone-III) derived from natural sources : 4 graded stone aggregate 40 mm nominal size derived from natural sources) | cum | 7,570.50 | |
| 4.1.5 | 1:3:6 (1 Cement : 3 coarse sand (zone-III) derived from natural sources : 6 graded stone aggregate 20 mm nominal size derived from natural sources) | cum | 7,098.00 | |
| 4.1.5A | 1:3:6 (1 Cement : 3 manufactured sand derived from Recycled Concrete Aggregate (RCA) : 6 graded stone aggregate 20 mm nominal size… | cum | 6,176.60 | |
| 4.1.5B | 1:3:6 (1 cement : 3 manufactured sand derived from Recycled concrete Aggregate (RCA) : 6 graded stone aggregate 20 mm nominal size… | cum | 5,487.80 | |
| 4.1.6 | 1:3:6 (1 Cement : 3 coarse sand (zone-III) derived from natural sources : 6 graded stone aggregate 40 mm nominal size derived from natural sources) | cum | 6,985.20 | |
| 4.1.6A | 1:3:6 (1 Cement : 3 manufactured sand derived from Recycled Concrete Aggregate (RCA) : 6 graded stone aggregate 40 mm nominal size… | cum | 5,421.75 | |
| 4.1.8 | 1:4:8 (1 Cement : 4 coarse sand (zone-III) derived from natural sources : 8 graded stone aggregate 40 mm nominal size derived from natural sources) | cum | 6,628.30 | |
| 4.1.8A | 1:4:8 (1 cement : 4 manufactured sand derived from Recycled Concrete Aggregate (RCA) : 8 graded stone aggregate 40 mm nominal size… | cum | 5,064.90 | |
| Code | Description | Unit | Rate (₹) | |
|---|---|---|---|---|
| 20.1 | Providing, driving with hydraulic piling rigs with power units and installing driven cast-in-situ reinforced cement concrete piles of grade M-25… | |||
| 20.1.1 | 400 mm dia piles | metre | 2,692.40 | |
| 20.1.2 | 450 mm dia piles | metre | 3,338.15 | |
| 20.1.3 | 500 mm dia piles | metre | 4,018.55 | |
| 20.1.4 | 550 mm dia piles | metre | 4,408.70 | |
| 20.1.5 | 750 mm dia piles | metre | 7,529.85 | |
| 20.1.6 | 1000 mm dia piles | metre | 12,404.70 | |
| 20.1.7 | 1200 mm dia piles | metre | 16,221.50 | |
| 20.1.8 | 1500 mm dia piles | metre | 22,942.00 | |
| 20.2 | Boring, providing and installation bored cast-in-situ reinforced cement concrete piles… | |||
| 20.2.1 | 450 mm dia piles | metre | 2,216.90 | |
| 20.2.2 | 500 mm dia piles | metre | 2,630.35 | |
| 20.2.3 | 600 mm dia piles | metre | 3,539.15 | |
| 20.2.4 | 750 mm dia piles | metre | 5,430.70 | |
No items selected
In Costimator, items are picked from Earthwork, Concrete Work and Pile Work using the subhead dropdown and collect in a tray, with nothing typed.
In Costimator, items are picked from Earthwork, Concrete Work and Pile Work using the subhead dropdown and collect in a tray, with nothing typed.
| Code | Description | Unit | Rate (₹) | Quantity | Amount (₹) | |
|---|---|---|---|---|---|---|
| 2.6 | Earth work in excavation by mechanical means (Hydraulic excavator)/manual means over areas (exceeding 30 cm in depth, 1.5 m in width as well as 10 sqm on plan)… | |||||
| 2.6.1 | All kinds of soil | cum | 172.75 | 180 | 31,095.00 | |
| 2.8 | Earth work in excavation by mechanical means (Hydraulic excavator) / manual means in foundation trenches or drains (not exceeding 1.5 m in width or 10 sqm on plan)… | |||||
| 2.8.1 | All kinds of soil. | cum | 253.30 | 63.66 | 16,125.08 | |
| 4.1 | Providing and laying in position cement concrete of specified grade excluding the cost of centering and shuttering - All work up to plinth level : | |||||
| 4.1.8 | 1:4:8 (1 Cement : 4 coarse sand (zone-III) derived from natural sources : 8 graded stone aggregate 40 mm nominal size derived from natural sources) | cum | 6,628.30 | 12.5 | 82,853.75 | |
| 20.1 | Providing, driving with hydraulic piling rigs with power units and installing driven cast-in-situ reinforced cement concrete piles of grade M-25… | |||||
| 20.1.1 | 400 mm dia piles | metre | 2,692.40 | 120 | 3,23,088.00 | |
| 20.1.2 | 450 mm dia piles | metre | 3,338.15 | 80 | 2,67,052.00 | |
2.8.1In Costimator, quantities are typed directly, and item 2.8.1 is measured in its own measurement window, deduction included, giving 63.66 cum.
In Costimator, quantities are typed directly, and item 2.8.1 is measured in its own measurement window, deduction included, giving 63.66 cum.

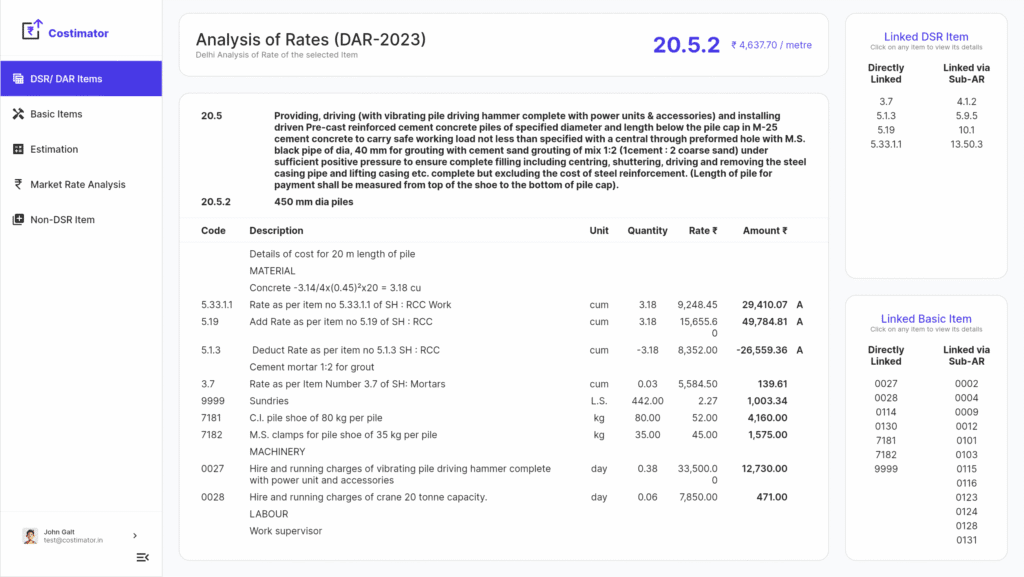

| Code | Description | Unit | Quantity | Rate (₹) | % Breakup% | Amount (₹) |
|---|---|---|---|---|---|---|
| 5.3 | RCC in beams, suspended floors and roofsMAX | cum | 375.68 | 11,195.25 | 8.6% | 42,05,831.54 |
| 20.1.3 | Driven cast-in-situ piles, 500 mm dia | metre | 925.11 | 4,018.55 | 7.6% | 37,17,600.78 |
| 5.1.2 | RCC 1:1.5:3, all work up to plinth level | cum | 421.13 | 8,801.85 | 7.6% | 37,06,723.09 |
| 5.2.2 | RCC 1:1.5:3 in walls (any thickness) | cum | 270.17 | 10,560.30 | 5.9% | 28,53,076.23 |
| 6.4.2 | Brick work above plinth, F.P.S. bricks in CM 1:6 | cum | 307.75 | 8,860.40 | 5.6% | 27,26,788.10 |
| 4.1.3 | PCC 1:2:4 with 20 mm aggregate, up to plinth | cum | 305.44 | 7,666.05 | 4.8% | 23,41,518.31 |
| 5.1.3 | RCC 1:2:4, all work up to plinth level | cum | 277.93 | 8,352.00 | 4.8% | 23,21,271.36 |
| 6.1.1 | Brick work, F.P.S. bricks in cement mortar 1:4 | cum | 313.89 | 7,171.90 | 4.6% | 22,51,187.69 |
| 4.1.5 | PCC 1:3:6 with 20 mm aggregate, up to plinth | cum | 315.07 | 7,098.00 | 4.6% | 22,36,366.86 |
| 11.7 | CC pavement 1:2:4 | cum | 259.02 | 8,363.35 | 4.4% | 21,66,274.93 |

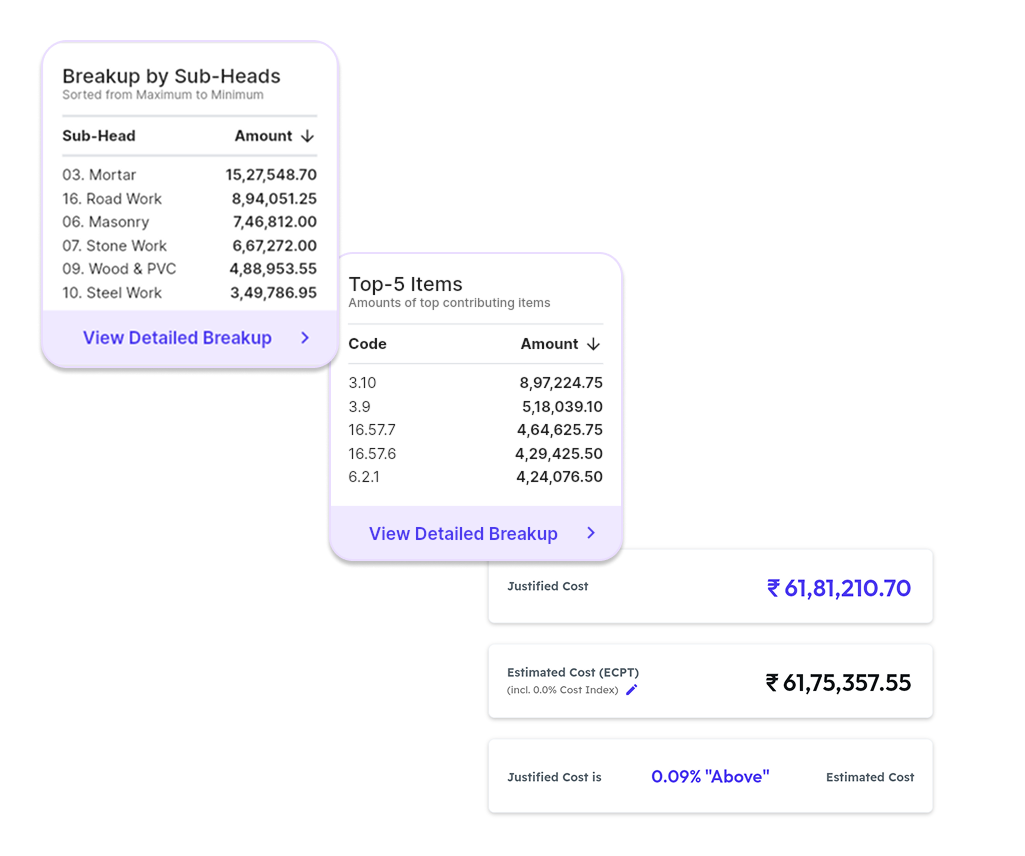

5.3 top itemEstimate Total₹4,87,00,035.63Costimator breaks the same ₹4.87 crore estimate down by subhead in a donut chart, led by Reinforced Cement Concrete at 26.9%, and lists the top items.
Costimator breaks the same ₹4.87 crore estimate down by subhead in a donut chart, led by Reinforced Cement Concrete at 26.9%, and lists the top items.
| Code | Resource Description | Unit | Rate (₹) | Quantity | Amount (₹) | |
|---|---|---|---|---|---|---|
| MATERIAL14 resources | ||||||
| 0367 | Portland Cement (OPC-43 Grade) | tonne | 5,156.00 | 16.21 | 83,553.55 | 10.7% |
| 7181 | C.I. pile shoe | kg | 52.00 | 1,040 | 54,080.00 | 6.9% |
| 0295 | Stone Aggregate (Single size) : 20 mm nominal size | cum | 1,425.00 | 27.32 | 38,931.27 | 5.0% |
| 0982 | Coarse sand (zone III) | cum | 1,450.00 | 24.01 | 34,812.29 | 4.5% |
| 7182 | M.S. clamps for pile shoe of 35 kg per pile | kg | 45.00 | 455 | 20,475.00 | 2.6% |
| 0297 | Stone Aggregate (Single size) : 10 mm nominal size | cum | 1,400.00 | 11.95 | 16,725.46 | 2.1% |
| 0293 | Stone Aggregate (Single size) : 40 mm nominal size | cum | 1,400.00 | 8.13 | 11,375.00 | 1.5% |
| 9999 | Sundries | L.S. | 2.27 | 3,854.21 | 8,749.05 | 1.1% |
| 7318 | Plasticizer / super plasticizer | kg | 30.00 | 70.4 | 2,112.02 | 0.3% |
| 7183 | Bentonite of 35 kg per pile | tonne | 3,050.00 | 0.32 | 976.00 | 0.1% |
| 2209 | Carriage of Cement | tonne | 0.00 | 16.21 | 0.00 | 0.0% |
| 2203 | Carriage of Coarse sand | cum | 0.00 | 24.01 | 0.00 | 0.0% |
| 2206 | Carriage of Stone aggregate 40 mm nominal size and above | cum | 0.00 | 8.13 | 0.00 | 0.0% |
| 2202 | Carriage of Stone aggregate below 40 mm nominal size | cum | 0.00 | 39.27 | 0.00 | 0.0% |
| Material subtotal | 2,71,789.63 | 34.8% | ||||
| MANPOWER6 resources | ||||||
| 0114 | Beldar | day | 736.00 | 139.71 | 1,02,825.82 | 13.2% |
| 0101 | Bhisti | day | 816.00 | 47.15 | 38,474.64 | 4.9% |
| 0155 | Mason (average) | day | 857.00 | 8.5 | 7,287.41 | 0.9% |
| 0130 | Mistry | day | 897.00 | 1.36 | 1,219.92 | 0.2% |
| 0115 | Coolie | day | 736.00 | 1.46 | 1,076.00 | 0.1% |
| 0128 | Mate | day | 816.00 | 0.97 | 795.31 | 0.1% |
| Manpower subtotal | 1,51,679.10 | 19.4% | ||||
| MACHINERY9 resources | ||||||
| 0024 | Hire and running charges of hydraulic piling rig with power unit etc. | day | 39,500.00 | 7.32 | 2,89,140.00 | 37.0% |
| 0004 | Production cost of concrete by batch mix plant | cum | 450.00 | 42.67 | 19,200.15 | 2.5% |
| 0020 | Hydraulic Excavator (3D) with driver and fuel | day | 7,850.00 | 2.2 | 17,300.77 | 2.2% |
| 0018 | Hire and running charges of loader | day | 6,700.00 | 2.2 | 14,766.26 | 1.9% |
| 0009 | Pumping charges of concrete including hire charges of pump | cum | 250.00 | 42.67 | 10,666.75 | 1.4% |
| 0025 | Hire and running charges of light crane | day | 3,900.00 | 0.9 | 3,510.00 | 0.4% |
| 0012 | Vibrator (Needle type 40 mm) | day | 400.00 | 3.86 | 1,544.68 | 0.2% |
| 0002 | Hire charges of Concrete Mixer 0.25 to 0.40 cum with Hopper | day | 900.00 | 0.88 | 787.50 | 0.1% |
| 0026 | Hire and running charges of bentonite pump | day | 3,350.00 | 0.08 | 268.00 | 0.0% |
| Machinery subtotal | 3,57,184.11 | 45.8% | ||||
7,80,652.85Costimator’s resource takeoff totals material, manpower and machinery, and shows that cement’s 16.21 tonnes come from five items.
Costimator’s resource takeoff totals material, manpower and machinery, and shows that cement’s 16.21 tonnes come from five items.
Justification
From Market Rates to a Justified Estimate.
Adjust Margins (CPOH etc.)
Estimate Total
Publication Margins
Project Margins
Project Margins
Reset to Default| Sequence | Description | Publication Margin | Project Margin |
|---|---|---|---|
| 1 | Water Charges | 1.00 % | 1.00 % |
| 2 | CPOH | 15.00 % | 12.50 % |
| 3 | Labour Cess | 1.00 % | 1.00 % |
| 4 | GST | 18.00 % | 18.00 % |
Enter Resource Market Rates
| Code | Description | Unit | Quantity | DSR Rate (₹) | Market rate (₹) | ||
|---|---|---|---|---|---|---|---|
| Material14 resources0 changed | |||||||
| 0367 | Portland Cement (OPC-43 grade) | 2 | tonne | 16.21 | 5,156.00 | 5,156 | 0.0% |
| 0982 | Coarse sand (zone III) | 5 | cum | 24.01 | 1,450.00 | 1,450 | 0.0% |
| 7181 | C.I. pile shoe | 3 | kg | 1,040 | 52.00 | 52 | 0.0% |
| 0293 | Stone aggregate 40 mm | 4 | cum | 27.32 | 1,400.00 | 1,400 | 0.0% |
| 7182 | M.S. clamps for pile shoe | 3 | kg | 455 | 45.00 | 45 | 0.0% |
| Labour7 resources0 changed | |||||||
| 0114 | Beldar | 7 | day | 139.71 | 736.00 | 736 | 0.0% |
| 0101 | Bhisti | 5 | day | 47.15 | 816.00 | 816 | 0.0% |
| 0155 | Mason (average) | 4 | day | 8.50 | 857.00 | 857 | 0.0% |
Analysis of Rates (Market Rates)
| Code | Description | Unit | Quantity | Rate (₹) | Amount (₹) | Notation |
|---|---|---|---|---|---|---|
| Details of cost for 1 cum. | ||||||
| Labour: | ||||||
| 0114 | Beldar | day | 0.12 | 736.00 | 88.32 | |
| Sundries | 36.47 | |||||
| TOTAL | 124.79 | W | ||||
| Add 1% Water charges on "W" | 1.25 | |||||
| TOTAL | 126.04 | X | ||||
| Add 12.5% CPOH on "X" | 15.76 | |||||
| TOTAL | 141.80 | Y | ||||
| Add 1% Labour Cess on "Y" | 1.42 | |||||
| TOTAL | 143.22 | Z | ||||
| Add 18% GST on "Z" | 25.78 | |||||
| Cost of 1 cum | 169.00 | |||||
| Say | ₹ 169.00 | |||||
| Code | Description | Unit | Quantity | Rate (₹) | Amount (₹) | Notation |
|---|---|---|---|---|---|---|
| Details of cost for 1 cum. | ||||||
| Labour: | ||||||
| 0114 | Beldar | day | 0.18 | 736.00 | 132.48 | |
| Sundries | 50.50 | |||||
| TOTAL | 182.98 | W | ||||
| Add 1% Water charges on "W" | 1.83 | |||||
| TOTAL | 184.81 | X | ||||
| Add 12.5% CPOH on "X" | 23.10 | |||||
| TOTAL | 207.91 | Y | ||||
| Add 1% Labour Cess on "Y" | 2.08 | |||||
| TOTAL | 209.99 | Z | ||||
| Add 18% GST on "Z" | 37.80 | |||||
| Cost of 1 cum | 247.79 | |||||
| Say | ₹ 247.79 | |||||
| Code | Description | Unit | Quantity | Rate (₹) | Amount (₹) | Notation |
|---|---|---|---|---|---|---|
| Details of cost for 1 cum. | ||||||
| Material: | ||||||
| 0367 | Portland Cement | tonne | 0.32 | 5,156.00 | 1,649.92 | |
| 0982 | Coarse sand (zone III) | cum | 0.45 | 1,450.00 | 652.50 | |
| 0293 | Stone aggregate 40 mm | cum | 0.89 | 1,400.00 | 1,246.00 | |
| Labour: | ||||||
| 0114 | Beldar | day | 1.63 | 736.00 | 1,199.68 | |
| Sundries | 40.18 | |||||
| TOTAL | 4,788.28 | W | ||||
| Add 1% Water charges on "W" | 47.88 | |||||
| TOTAL | 4,836.16 | X | ||||
| Add 12.5% CPOH on "X" | 604.52 | |||||
| TOTAL | 5,440.68 | Y | ||||
| Add 1% Labour Cess on "Y" | 54.41 | |||||
| TOTAL | 5,495.09 | Z | ||||
| Add 18% GST on "Z" | 989.12 | |||||
| Cost of 1 cum | 6,484.21 | |||||
| Say | ₹ 6,484.21 | |||||
| Code | Description | Unit | Quantity | Rate (₹) | Amount (₹) | Notation |
|---|---|---|---|---|---|---|
| Details of cost for 1 metre. | ||||||
| 5.33.1.1 | Concrete M25 | cum | 0.13 | 9,264.80 | 1,204.42 | |
| 7181 | C.I. pile shoe | kg | 2.60 | 52.00 | 135.20 | |
| 7182 | M.S. clamps for pile shoe | kg | 0.90 | 45.00 | 40.50 | |
| 0114 | Beldar | day | 0.35 | 736.00 | 257.60 | |
| Sundries | 307.27 | |||||
| TOTAL | 1,944.99 | W | ||||
| Add 1% Water charges on "W" | 19.45 | |||||
| TOTAL | 1,964.44 | X | ||||
| Add 12.5% CPOH on "X" | 245.56 | |||||
| TOTAL | 2,210.00 | Y | ||||
| Add 1% Labour Cess on "Y" | 22.10 | |||||
| TOTAL | 2,232.10 | Z | ||||
| Add 18% GST on "Z" | 401.78 | |||||
| Cost of 1 metre | 2,633.88 | |||||
| Say | ₹ 2,633.88 | |||||
In Costimator, CPOH is changed once to 12.5% under Adjust Margins, the project margins fall from 38.43% to 35.42%, and the Analysis of Rates shows every item rebuilt with 12.5% CPOH.
In Costimator, CPOH is changed once to 12.5% under Adjust Margins, the project margins fall from 38.43% to 35.42%, and the Analysis of Rates shows every item rebuilt with 12.5% CPOH.
Enter Resource Market Rates
| Code | Description | Unit | Quantity | DSR Rate (₹) | Market rate (₹) | ||
|---|---|---|---|---|---|---|---|
| Material14 resources2 changed | |||||||
| 0367 | Portland Cement (OPC-43 grade) | 2 | tonne | 16.21 | 5,156.00 | 5,600 | ↑ 8.6% |
| 0982 | Coarse sand (zone III) | 5 | cum | 24.01 | 1,450.00 | 1,600 | ↑ 10.3% |
| 7181 | C.I. pile shoe | 3 | kg | 1,040 | 52.00 | 52 | 0.0% |
| 0293 | Stone aggregate 40 mm | 4 | cum | 27.32 | 1,400.00 | 1,400 | 0.0% |
| 7182 | M.S. clamps for pile shoe | 3 | kg | 455 | 45.00 | 45 | 0.0% |
| Labour7 resources1 changed | |||||||
| 0114 | Beldar | 7 | day | 139.71 | 736.00 | 780 | ↑ 6.0% |
| 0101 | Bhisti | 5 | day | 47.15 | 816.00 | 816 | 0.0% |
| 0155 | Mason (average) | 4 | day | 8.50 | 857.00 | 857 | 0.0% |
Source items (2)
-
4.1.8 -
5.33.1.1sub-item, one level down
Costimator's market rates list shows cement used by items 4.1.8 and 5.33.1.1; cement, coarse sand and Beldar are each entered once, and every analysis uses them.
Costimator's market rates list shows cement used by items 4.1.8 and 5.33.1.1; cement, coarse sand and Beldar are each entered once, and every analysis uses them.
Enter Resource Market Rates
Apply Rate Library| Code | Description | Unit | Quantity | DSR Rate (₹) | Market rate (₹) | ||
|---|---|---|---|---|---|---|---|
| Material14 resources5 changed | |||||||
| 0367 | Portland Cement (OPC-43 grade) | 2 | tonne | 16.21 | 5,156.00 | 5,600 | ↑ 8.6% |
| 0982 | Coarse sand (zone III) | 5 | cum | 24.01 | 1,450.00 | 1,600 | ↑ 10.3% |
| 7181 | C.I. pile shoe | 3 | kg | 1,040 | 52.00 | 54 | ↑ 3.8% |
| 0293 | Stone aggregate 40 mm | 4 | cum | 27.32 | 1,400.00 | 1,480 | ↑ 5.7% |
| 7182 | M.S. clamps for pile shoe | 3 | kg | 455 | 45.00 | 47 | ↑ 4.4% |
| Labour7 resources3 changed | |||||||
| 0114 | Beldar | 7 | day | 139.71 | 736.00 | 780 | ↑ 6.0% |
| 0101 | Bhisti | 5 | day | 47.15 | 816.00 | 860 | ↑ 5.4% |
| 0155 | Mason (average) | 4 | day | 8.50 | 857.00 | 910 | ↑ 6.2% |
Select your saved library rates to insert them into this project.
These rates will fill matching rows in Enter Resource Market Rates.
Applied from library
Pile works — Q3 2026A saved rate library, "Pile works — Q3 2026", is previewed and applied, and 18 market rates fill the matching rows, each marked as applied from the library.
A saved rate library, "Pile works — Q3 2026", is previewed and applied, and 18 market rates fill the matching rows, each marked as applied from the library.
Justification Statement
| Code | Description | Unit | Quantity | Market Rate (₹) | Market Amount (₹) | ± Change (₹) | Percent variance |
|---|---|---|---|---|---|---|---|
| 02. Earthwork 2 items | |||||||
| 2.6.1 | All kinds of soil | cum | 180 | 179.85 | 32,373.00 | 1,278.00 | ↑ 4.1% |
| 2.8.1 | All kinds of soil. | cum | 63.66 | 263.70 | 16,787.14 | 662.06 | ↑ 4.1% |
| 02. Earthwork Total | 49,160.14 | 1,940.06 | ↑ 4.1% | ||||
| 04. Concrete Work 1 item | |||||||
| 4.1.8 | 1:4:8 (1 Cement : 4 coarse sand : 8 graded stone aggregate 40 mm) | cum | 12.5 | 6,973.15 | 87,164.38 | 4,310.63 | ↑ 5.2% |
| 04. Concrete Work Total | 87,164.38 | 4,310.63 | ↑ 5.2% | ||||
| 20. Pile Work 4 items | |||||||
| 20.1.1 | 400 mm dia piles | metre | 120 | 2,774.20 | 3,32,904.00 | 9,816.00 | ↑ 3.0% |
| 20.1.2 | 450 mm dia piles | metre | 80 | 3,441.60 | 2,75,328.00 | 8,276.00 | ↑ 3.1% |
| 20.1.3 | 500 mm dia piles | metre | 60 | 4,145.90 | 2,48,754.00 | 7,641.00 | ↑ 3.2% |
| 20.3.1 | 300 mm dia piles | metre | 40 | 3,069.75 | 1,22,790.00 | 3,474.00 | ↑ 2.9% |
| 20. Pile Work Total | 9,79,776.00 | 29,207.00 | ↑ 3.1% | ||||
| 7 items
Justified Cost is 3.28% Above
ECPT
Grand Total | ₹11,16,100.52 | 35,457.69 | ↑ 3.3% | ||||
Resource Rate Variance
| Code | Resource Description | Unit | DSR Rate (₹) | Market Rate (₹) | Difference |
|---|---|---|---|---|---|
| Material 14 resources 6 changed | |||||
| 0367 | Portland Cement (OPC-43 grade) | tonne | 5,156.00 | 5,600.00 | 444.00 |
| 0982 | Coarse sand (zone III) | cum | 1,450.00 | 1,600.00 | 150.00 |
| 0293 | Stone aggregate 40 mm | cum | 1,400.00 | 1,480.00 | 80.00 |
| 7181 | C.I. pile shoe | kg | 52.00 | 54.00 | 2.00 |
| Labour 7 resources 3 changed | |||||
| 0155 | Mason (average) | day | 857.00 | 910.00 | 53.00 |
| 0114 | Beldar | day | 736.00 | 780.00 | 44.00 |
| 0101 | Bhisti | day | 816.00 | 860.00 | 44.00 |
DSR Rate Variance
| Code | Description | Unit | DSR Rate (₹) | Market Rate (₹) | Difference |
|---|---|---|---|---|---|
| 02. Earthwork 2 items 2 changed | |||||
| 2.8.1 | All kinds of soil. | cum | 253.30 | 263.70 | 10.40 |
| 2.6.1 | All kinds of soil | cum | 172.75 | 179.85 | 7.10 |
| 04. Concrete Work 1 item 1 changed | |||||
| 4.1.8 | 1:4:8 (1 Cement : 4 coarse sand : 8 graded stone aggregate 40 mm) | cum | 6,628.30 | 6,973.15 | 344.85 |
| 20. Pile Work 4 items 4 changed | |||||
| 20.1.3 | 500 mm dia piles | metre | 4,018.55 | 4,145.90 | 127.35 |
| 20.1.2 | 450 mm dia piles | metre | 3,338.15 | 3,441.60 | 103.45 |
| 20.3.1 | 300 mm dia piles | metre | 2,982.90 | 3,069.75 | 86.85 |
| 20.1.1 | 400 mm dia piles | metre | 2,692.40 | 2,774.20 | 81.80 |
Breakup by Subheads
Download Excel| Sub Heads | % Breakup | Market Amount (₹) |
|---|---|---|
| 02 Earthwork Min | 4.4% | 49,160.14 |
| 04 Concrete Work | 7.8% | 87,164.38 |
| 20 Pile Work Max | 87.8% | 9,79,776.00 |
Costimator's Justification Statement totals ₹11,16,100.52, 3.28% above ECPT; the rate variance reports and the breakup by subheads open from the reports list, and the statement downloads as an Excel file.
Costimator's Justification Statement totals ₹11,16,100.52, 3.28% above ECPT; the rate variance reports and the breakup by subheads open from the reports list, and the statement downloads as an Excel file.
Analysis of Rates (Market Rates)
Main Items Sub-AR Items Sub-Sub-AR Items| Code | Description | Unit | Quantity | Rate (₹) | Amount (₹) | Notation |
|---|---|---|---|---|---|---|
| Details of cost for 1 cum. | ||||||
| Material: | ||||||
| 0367 | Portland Cement | tonne | 0.32 | 5,600.00 | 1,792.00 | |
| 0982 | Coarse sand (zone III) | cum | 0.45 | 1,600.00 | 720.00 | |
| 0295 | Stone aggregate 20 mm | cum | 0.89 | 1,480.00 | 1,317.20 | |
| Labour: | ||||||
| 0114 | Beldar | day | 1.63 | 780.00 | 1,271.40 | |
| 0155 | Mason (average) | day | 0.17 | 910.00 | 154.70 | |
| 0101 | Bhisti | day | 0.70 | 860.00 | 602.00 | |
| Sundries | 347.66 | |||||
| TOTAL | 6,204.96 | W | ||||
| Add 1% Water charges on "W" | 62.05 | |||||
| TOTAL | 6,267.01 | X | ||||
| Add 12.5% CPOH on "X" | 783.38 | |||||
| TOTAL | 7,050.39 | Y | ||||
| Add 1% Labour Cess on "Y" | 70.50 | |||||
| TOTAL | 7,120.89 | Z | ||||
| Add 18% GST on "Z" | 1,281.76 | |||||
| Cost of 1 cum | 8,402.65 | |||||
| Say | ₹ 8,402.65 | |||||
| Code | Description | Unit | Quantity | Rate (₹) | Amount (₹) | Notation |
|---|---|---|---|---|---|---|
| Details of cost for 1 cum. | ||||||
| 4.1.2 | CC 1:1½:3 | cum | 0.27 | 8,402.65 | 2,268.72 | |
| 0367 | Portland Cement | tonne | 0.11 | 5,600.00 | 616.00 | |
| Labour: | ||||||
| 0114 | Beldar | day | 2.10 | 780.00 | 1,638.00 | |
| 0155 | Mason (average) | day | 0.50 | 910.00 | 455.00 | |
| Centering and shuttering | 6,890.18 | |||||
| TOTAL | 11,867.90 | W | ||||
| Add 1% Water charges on "W" | 118.68 | |||||
| TOTAL | 11,986.58 | X | ||||
| Add 12.5% CPOH on "X" | 1,498.32 | |||||
| TOTAL | 13,484.90 | Y | ||||
| Add 1% Labour Cess on "Y" | 134.85 | |||||
| TOTAL | 13,619.75 | Z | ||||
| Add 18% GST on "Z" | 2,451.56 | |||||
| Cost of 1 cum | 16,071.31 | |||||
| Say | ₹ 16,071.30 | |||||
| Code | Description | Unit | Quantity | Rate (₹) | Amount (₹) | Notation |
|---|---|---|---|---|---|---|
| Details of cost for 20 m pile. | ||||||
| 5.33.1.1 | Concrete M25 | cum | 3.18 | 9,512.40 | 30,249.43 | |
| 5.19 | Encasing rolled steel sections with CC 1:1.5:3 | cum | 0.12 | 16,071.30 | 1,928.56 | |
| 1005 | Twisted steel TMT bars Fe-500D | quintal | 4.00 | 5,725.00 | 22,900.00 | |
| Hire of piling rig, labour and sundries | 14,424.46 | |||||
| TOTAL | 69,502.45 | W | ||||
| Add 1% Water charges on "W" | 695.02 | |||||
| TOTAL | 70,197.47 | X | ||||
| Add 12.5% CPOH on "X" | 8,774.68 | |||||
| TOTAL | 78,972.15 | Y | ||||
| Add 1% Labour Cess on "Y" | 789.72 | |||||
| TOTAL | 79,761.87 | Z | ||||
| Add 18% GST on "Z" | 14,357.14 | |||||
| Cost of 20 m pile | 94,119.01 | |||||
| Rate per metre | 4,705.95 | |||||
| Say | ₹ 4,705.95 | |||||
Costimator's Analysis of Rates at market rates shows all three levels: 4.1.2 at ₹8,402.65 is carried into 5.19, and 5.19 at ₹16,071.30 into 20.5.2, which comes to ₹4,705.95 per metre.
Costimator's Analysis of Rates at market rates shows all three levels: 4.1.2 at ₹8,402.65 is carried into 5.19, and 5.19 at ₹16,071.30 into 20.5.2, which comes to ₹4,705.95 per metre.
Non-Scheduled Items
Not in the schedule? Make it.
Add your own resources, build the item with a full rate analysis, and pick it like any schedule item.
Precast kerb stone, 300 × 150 mm
- Unit
- each
- Rate
- ₹185.00
Kerb laying with precast stone · per metre
| Resource | Quantity × rate | Amount |
|---|---|---|
| Precast kerb stone | 3.33 × 185.00 | 616.05 |
| Beldar | 0.10 × 736.00 | 73.60 |
| Mason | 0.05 × 1,050.00 | 52.50 |
| Water charges 1% · CPOH 15% | 119.86 | |
| Say (per metre) | 862.00 | |
Select Items
XLSX · Excel download
Every report you submit, built for you.
Check it on screen, then download it as a formatted Excel file.
| Code | Description | QuantityQty | Rate (₹)Rate ₹ | Amount (₹)Amount ₹ | |||
|---|---|---|---|---|---|---|---|
| 04. Concrete Work3 items | |||||||
| 4.1.3 | 1:2:4 · 20 mm aggregate | 14.2 | 7,666.05 | 1,08,857.91 | |||
| 4.1.4 | 1:2:4 · 40 mm aggregate | 21.6 | 7,570.50 | 1,63,522.80 | |||
| 4.1.5 | 1:3:6 · 20 mm aggregate | 9.6 | 7,098.00 | 68,140.80 | |||
| 04. Concrete Work subtotal | 04. Concrete Work subtotal | 3,40,521.51 | |||||
| 05. Reinforced Cement Concrete2 items | |||||||
| 5.1.3 | 1:2:4 · 20 mm aggregate | 20.79 | 8,352.00 | 1,73,638.08 | |||
| 5.22.6 | TMT bars, Fe-500D or more | 4,250 | 104.95 | 4,46,037.50 | |||
| 05. Reinforced Cement Concrete subtotal | 05. Reinforced Cement Concrete subtotal | 6,19,675.58 | |||||
| Particulars | Nos. | L | B | H/D | QuantityQty | ||
|---|---|---|---|---|---|---|---|
| 02. Earthwork1 item | |||||||
| 2.8.1 All kinds of soil. | |||||||
| Long walls, north | 2 | 14.6 | 1.2 | 1.5 | 52.56 | ||
| Long walls, south | 2 | 14.6 | 1.2 | 1.5 | 52.56 | ||
| Cross walls, east | 3 | 8.4 | 1.2 | 1.5 | 45.36 | ||
| Cross walls, west | 3 | 8.4 | 1.2 | 1.5 | 45.36 | ||
| Deduct: wall junctions | -12 | 1.2 | 1.2 | 1.5 | -25.92 | ||
| Total Quantity (cum) | Total Quantity (cum) | 169.92 | |||||
| Sub-Heading | % Breakup% | CI Amount (₹)CI Amt ₹ | |
|---|---|---|---|
| 05 Reinforced Cement ConcreteMAX | 26.9% | 1,30,86,902.22 | |
| 20 Pile Work | 22.9% | 1,11,48,556.39 | |
| 06 Masonry Work | 16.2% | 78,79,697.55 | |
| 04 Concrete Work | 13.9% | 67,45,393.58 | |
| 11 Flooring | 12.5% | 60,64,108.45 | |
| 13 Finishing | 3.1% | 15,01,758.97 | |
| 02 Earthwork | 2.2% | 10,68,661.12 | |
| 22 Water Proofing | 1.5% | 7,45,268.31 | |
| 26 New Technologies & MaterialsMIN | 0.9% | 4,59,689.04 |
| Code | Description | % Breakup% | Amount (₹)Amount ₹ |
|---|---|---|---|
| 5.3 | RCC in beams, suspended floors and roofsMAX | 8.6% | 42,05,831.54 |
| 20.1.3 | Driven cast-in-situ piles, 500 mm dia | 7.6% | 37,17,600.78 |
| 5.1.2 | RCC 1:1.5:3, all work up to plinth level | 7.6% | 37,06,723.09 |
| 5.2.2 | RCC 1:1.5:3 in walls (any thickness) | 5.9% | 28,53,076.23 |
| 6.4.2 | Brick work above plinth, F.P.S. bricks in CM 1:6 | 5.6% | 27,26,788.10 |
| 4.1.3 | PCC 1:2:4 with 20 mm aggregate, up to plinth | 4.8% | 23,41,518.31 |
| 5.1.3 | RCC 1:2:4, all work up to plinth level | 4.8% | 23,21,271.36 |
| Code | Resource DescriptionResource | Unit | Rate (₹)Rate ₹ | QuantityQty | Amount (₹)Amount ₹ | |||
|---|---|---|---|---|---|---|---|---|
| Material7 resources | ||||||||
| 1005 | Twisted steel/ deformed TMT bars Fe-500D | quintal | 5,550.00 | 44.63 | 2,47,696.50 | |||
| 0367 | Portland Cement (OPC-43 Grade) | tonne | 5,156.00 | 20.86 | 1,07,554.16 | |||
| 0295 | Stone Aggregate (Single size) : 20 mm | cum | 1,425.00 | 36.72 | 52,326.00 | |||
| 0982 | Coarse sand (zone III) | cum | 1,450.00 | 34.85 | 50,532.50 | |||
| 0293 | Stone Aggregate (Single size) : 40 mm | cum | 1,400.00 | 19.44 | 27,216.00 | |||
| 0297 | Stone Aggregate (Single size) : 10 mm | cum | 1,400.00 | 12.08 | 16,912.00 | |||
| 0983 | Fine sand (zone IV) | cum | 980.00 | 9.80 | 9,604.00 | |||
| Material subtotal | Material subtotal | 5,11,841.16 | ||||||
| Manpower4 resources | ||||||||
| 0114 | Beldar | day | 736.00 | 214.60 | 1,57,945.60 | |||
| 0101 | Bhisti | day | 816.00 | 58.40 | 47,654.40 | |||
| 0123 | Mason 1st class | day | 897.00 | 44.10 | 39,557.70 | |||
| 0155 | Mason (average) | day | 857.00 | 12.30 | 10,541.10 | |||
| Manpower subtotal | Manpower subtotal | 2,55,698.80 | ||||||
| Code | Description | Market Amount (₹)Mkt Amt ₹ | ± Change (₹)± ₹ | % |
|---|---|---|---|---|
| 02. Earthwork2 items | ||||
| 2.6.1 | All kinds of soil | 32,373.00 | 1,278.00 | ↑ 4.1% |
| 2.8.1 | All kinds of soil. | 16,787.14 | 662.06 | ↑ 4.1% |
| 02. Earthwork Total | 49,160.14 | 1,940.06 | ↑ 4.1% | |
| 04. Concrete Work1 item | ||||
| 4.1.8 | 1:4:8 (1 Cement : 4 coarse sand : 8 graded stone aggregate 40 mm) | 87,164.38 | 4,310.63 | ↑ 5.2% |
| 04. Concrete Work Total | 87,164.38 | 4,310.63 | ↑ 5.2% | |
| 20. Pile Work4 items | ||||
| 20.1.1 | 400 mm dia piles | 3,32,904.00 | 9,816.00 | ↑ 3.0% |
| 20.1.2 | 450 mm dia piles | 2,75,328.00 | 8,276.00 | ↑ 3.1% |
| 20.1.3 | 500 mm dia piles | 2,48,754.00 | 7,641.00 | ↑ 3.2% |
| 20.3.1 | 300 mm dia piles | 1,22,790.00 | 3,474.00 | ↑ 2.9% |
| 20. Pile Work Total | 9,79,776.00 | 29,207.00 | ↑ 3.1% | |
| Code | Description | QuantityQty | Rate (₹)Rate ₹ | Amount (₹)Amount ₹ | |||
|---|---|---|---|---|---|---|---|
| 04 - Concrete Work1 item | |||||||
| 4.1.2 CC 1:1½:3 (1 cement : 1½ coarse sand : 3 graded stone aggregate 20 mm) | |||||||
| Details of cost for 1 cum. | |||||||
| Material: | |||||||
| 0367 | Portland Cement | 0.32 | 5,600.00 | 1,792.00 | |||
| 0982 | Coarse sand (zone III) | 0.45 | 1,600.00 | 720.00 | |||
| 0295 | Stone aggregate 20 mm | 0.89 | 1,480.00 | 1,317.20 | |||
| Labour: | |||||||
| 0114 | Beldar | 1.63 | 780.00 | 1,271.40 | |||
| 0155 | Mason (average) | 0.17 | 910.00 | 154.70 | |||
| 0101 | Bhisti | 0.70 | 860.00 | 602.00 | |||
| Sundries | 347.66 | ||||||
| TOTAL | 6,204.96 | ||||||
| Add 1% Water charges on "W" | 62.05 | ||||||
| TOTAL | 6,267.01 | ||||||
| Add 12.5% CPOH on "X" | 783.38 | ||||||
| TOTAL | 7,050.39 | ||||||
| Add 1% Labour Cess on "Y" | 70.50 | ||||||
| TOTAL | 7,120.89 | ||||||
| Add 18% GST on "Z" | 1,281.76 | ||||||
| Say | Say | ₹ 8,402.65 | |||||
| Code | Resource DescriptionResource | DSR Rate (₹)DSR ₹ | Market Rate (₹)Mkt ₹ | DifferenceDiff. |
|---|---|---|---|---|
| Material14 resources · 6 changed | ||||
| 0367 | Portland Cement (OPC-43 grade) | 5,156.00 | 5,600.00 | 444.00 |
| 0982 | Coarse sand (zone III) | 1,450.00 | 1,600.00 | 150.00 |
| 0293 | Stone aggregate 40 mm | 1,400.00 | 1,480.00 | 80.00 |
| 7181 | C.I. pile shoe | 52.00 | 54.00 | 2.00 |
| 7182 | M.S. clamps for pile shoe | 45.00 | 45.00 | — |
| Manpower7 resources · 3 changed | ||||
| 0155 | Mason (average) | 857.00 | 910.00 | 53.00 |
| 0114 | Beldar | 736.00 | 780.00 | 44.00 |
| 0101 | Bhisti | 816.00 | 860.00 | 44.00 |
| Code | Description | DSR Rate (₹)DSR ₹ | Market Rate (₹)Mkt ₹ | DifferenceDiff. |
|---|---|---|---|---|
| 02. Earthwork2 items · 2 changed | ||||
| 2.8.1 | All kinds of soil. | 253.30 | 263.70 | 10.40 |
| 2.6.1 | All kinds of soil | 172.75 | 179.85 | 7.10 |
| 04. Concrete Work1 item · 1 changed | ||||
| 4.1.8 | 1:4:8 (1 Cement : 4 coarse sand : 8 graded stone aggregate 40 mm) | 6,628.30 | 6,973.15 | 344.85 |
| 20. Pile Work4 items · 4 changed | ||||
| 20.1.3 | 500 mm dia piles | 4,018.55 | 4,145.90 | 127.35 |
| 20.1.2 | 450 mm dia piles | 3,338.15 | 3,441.60 | 103.45 |
| 20.3.1 | 300 mm dia piles | 2,982.90 | 3,069.75 | 86.85 |
| 20.1.1 | 400 mm dia piles | 2,692.40 | 2,774.20 | 81.80 |
- Bill of Quantities
- Detailed Measurements
- Breakup by Subheads
- Breakup by Top Items
- Resource Takeoff
- Justification Statement
- Analysis of Rates
- Resource Rate Variance
- DSR Rate Variance
Sharing
Share your work. Use theirs.
Publish what you have built, or add what someone else has published. Every copy is yours to edit.
- Project Boundary wall, 120 m
- Non-SOR item Kerb laying, precast stone
- Rate library Market rates, Ward 7
Share a project, a Non-SOR item and a rate library together by email. Each person gets their own copy to edit.
Whoever adds it gets their own copy. Your original stays yours.
Nothing to install
Open it and work. Anywhere.
Chrome, Safari, Firefox or Edge.
Desktop, tablet or phone.
The founder
Built by someone who did the estimating.
I spent years preparing estimates as an Executive Engineer at CPWD, and built a tool for my own work that colleagues started using. In 2025 I left the Indian Engineering Services to build Costimator full-time.
Kushal Singh
Founder, Costimator
Ex-IES Officer (2014 batch) · Ex-CPWD, MoHUA
Frequently asked questions
-
What does the free trial include?
14 days of Costimator on one publication you choose when you start, with estimation, justification, Non-SOR items and every report. The trial allows up to 3 projects of 20 items each, 3 Non-SOR items and one rate library. No card is needed, so nothing is charged when the trial ends. Compare the plans →
-
Which rate books are available?
CPWD DSR-2023 (Civil) with its DAR, under both the new GST methodology in CPWD’s OM dated 08-08-2024 and the earlier one; and Railways USSOR-2021 (Civil) with its analysis of rates. Working from a different schedule? Tell us which one .
-
Will the rates match the published schedule?
Every rate is built from the schedule’s own analysis data (its resources, sub-items and margins, such as the 15% CP&OH ), with the full working shown, so you can check any rate against the book. The calculations were checked by hand to the paisa.
-
How are rates kept up to date?
When a new edition, correction slip or methodology OM is published for a rate book we carry, we add it. You don’t track the changes yourself.
-
Can I bring my existing estimate?
Yes. Upload your BOQ as Excel (.xlsx), CSV or a digital PDF, map its code, description and quantity columns, review the matches, and Costimator creates the project. It works on the trial too, within its limits. Scanned PDFs aren’t supported.
-
Can I add items that aren’t in the schedule?
Yes. Build a Non-SOR item with its own analysis from the publication’s resources, other SoR items or custom resources, and add it to any estimate.
-
Can I share my work?
On paid plans, share project templates, Non-SOR items and rate libraries: on the Marketplace, with specific people (up to 20, by email), or to your organisation’s Team Library on Teams. Each person gets their own copy. See how sharing works .
-
Do I need to install anything?
No. Open the site, sign in and work in any browser on Windows, Mac or Linux. No USB keys or licence files. Every report downloads as Excel.
-
Can my office buy on a government purchase order?
Yes. Central and state departments, PSUs and autonomous bodies can buy on a PO. Send the PO with the plan details and we activate the subscription. For a department-wide licence, contact us first.
Your next estimate starts here.
14 days free on one publication. No card needed.
Buying for a department? Contact sales
